Remodel Permits: What Needs One and How the Process Works

A permit is the city or county reviewing the plan before work starts, then inspecting the work after it is built. Homeowners often experience permitting as friction. I see it as protection: for you, for the project, and for the value of the house.

Unpermitted work has a way of surfacing at resale, during an appraisal, or during an insurance claim, exactly when you least want to explain it. Permits do not make a project perfect, but they create a record and bring another trained set of eyes into the process.

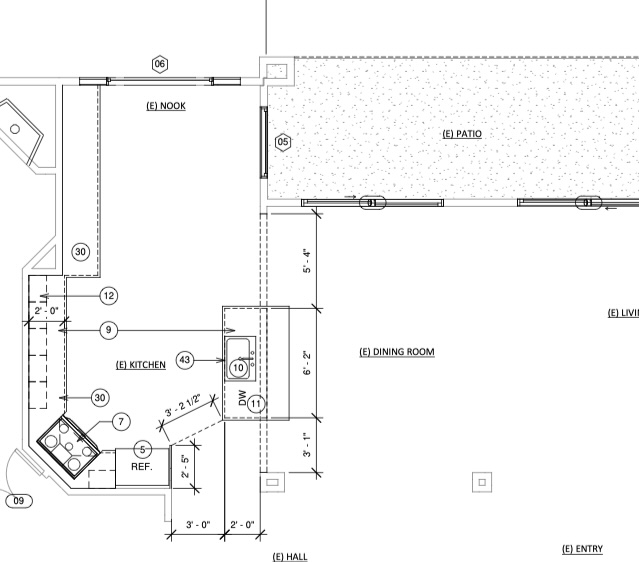

Submitted kitchen remodel floor plan showing existing and proposed work
A permit submittal should give the jurisdiction enough information to understand the proposed changes before work begins.

What Usually Needs a Permit

Rules vary by jurisdiction, so treat this as the pattern, not a substitute for checking your city or county. A permit is commonly required when the work will:

  • move or add plumbing, including relocating a fixture or drain
  • add electrical circuits or upgrade the service panel
  • alter, remove, or add walls
  • change structural elements or the roof
  • build an addition, convert a garage, or add an ADU
  • change many windows or exterior doors, especially if the opening size changes
  • replace or relocate water heaters, furnaces, or HVAC equipment

Cosmetic work in the same footprint may not require a permit. Paint, flooring, countertops, cabinet refacing, and like-for-like fixture swaps are often simpler. When you are not sure, one call to the building department is worth making before you sign a bid.

Start With the Right Jurisdiction

The first question is who has authority over your address. If you are inside city limits, the city usually permits the work. If you are in an unincorporated area, the county usually does, even if your mailing address names a nearby city.

A quick way to confirm is to search your county assessor or parcel lookup for your address. You can also call the city building department and ask whether the property is actually in their jurisdiction.

Once you know the jurisdiction, look for the building or building-and-safety department. Many publish project handouts, submittal checklists, fee schedules, plan-check instructions, online permit portals, and local amendments to the code.

Over-the-Counter Permits Versus Plan Check

The jurisdiction may handle small, well-defined work over the counter. You submit the required information, a plans examiner reviews it quickly, and the jurisdiction may issue the permit the same day or within a short window. A water heater replacement or a like-for-like reroof may require an even simpler process.

Larger projects usually go through plan check. Staff log the submittal, route it to one or more departments, review it, and return comments. Comments are normal. The city may ask for clarification, a missing sheet, engineering, energy documentation, or details that were not obvious at first.

You respond, resubmit, and repeat until the project clears. Each round takes time, which is why permitting can quietly become the longest stretch of the schedule. Build the calendar around plan check, not the other way around.

What to Bring or Submit

The package depends on the scope, but a project that needs drawings may require:

  • the plan set, either electronic or printed as required by the jurisdiction
  • a completed permit application
  • the property address and assessor parcel number
  • structural calculations when structural work is involved
  • Title 24 energy documentation when the work triggers it
  • HOA approval if the jurisdiction requires it before submittal
  • soils or geotechnical information for some hillside work, additions, or site conditions
  • contractor license information once you select the contractor
  • payment for plan check, permit fees, or the first portion of them

For a simple permit, that list may shrink dramatically. Match the package to the work you are actually doing.

Title 24, HOAs, and Other Parallel Reviews

Title 24 is California’s energy code. Your designer, architect, engineer, or contractor should know when it applies and what documentation the jurisdiction needs. I have a separate article on Title 24 remodel requirements because it deserves its own explanation.

Your HOA, if you have one, is not the permitting authority. The HOA usually reviews appearance and community rules. The city or county reviews code, setbacks, safety, and permit requirements. Do the HOA approval early because some jurisdictions want that approval letter in the permit submittal, and an HOA can take weeks to respond.

Who Should Pull the Permit?

Usually the contractor pulls the permit under their license. That is the right default because it puts responsibility for the work on the licensed party performing or managing it.

A homeowner can pull a permit as an owner-builder, but that carries obligations most people do not want, including responsibility for the work and potential responsibility for people performing it. If a contractor asks you to pull the permit yourself so they do not have to, treat that as a flag, not a favor.

Inspections Are Part of the Permit

Inspections happen at stages. A project may have rough inspections when framing, plumbing, mechanical, and electrical work are open and visible, then a final inspection when the team completes the work. The inspector confirms that the work matches the approved plans and meets code.

When several systems are ready at the same time, the team can sometimes coordinate inspections so rough framing, rough electrical, rough plumbing, and similar items happen in a grouped visit. That can help the schedule, especially when walls cannot close until multiple approvals are complete.

But some inspections need to happen at a specific moment. A city may want to witness a shower pan or hot-mop water test, for example. The contractor, or you if you are managing the project yourself, should ask the inspector about expectations early. It is much better to know the inspection sequence before the team covers, tiles, or closes the work.

Changes During Construction Can Reopen the Permit Question

A mid-project change can require an updated permit. Not always, but if the change touches structure, plumbing, electrical, or anything already inspected, ask before it is built. Inspectors would generally rather answer a question early than fail a final and require the team to open a wall again.

Why This Belongs in the Planning Phase

Permits document the work. It is something you can show a buyer, an appraiser, and an insurer without a story attached. It also gives the project a review path before the work becomes expensive to correct.

Master Build Advisor helps homeowners find out what the jurisdiction is likely to require before the team finalizes drawings. That way, the permit set and the bid set can support the same scope, and the schedule can allow for plan check from the start.

The objective is not more paperwork. It is fewer assumptions.

Your project. A clear scope. Confident decisions.

Plan the permit path before construction begins.

Use the Planning Guide to organize scope, budget, timeline, and decisions, or book a free 20-minute call if you want help understanding what to ask your jurisdiction before bidding.
