Planning Series | Article 2 of 5
How to define the work clearly enough to price, compare, and build.
Once you have defined what you want your remodel to accomplish, the next step is defining what work actually needs to happen.
This is where a project starts becoming real.
“Remodel the kitchen” is not a scope. Neither is “redo the bathroom,” “open up the wall,” or “replace the flooring.” Those phrases describe an intention, but they do not tell a contractor exactly what is included, what is changing, what stays, or what assumptions should be made when pricing the work.
If two contractors are filling in those blanks differently, their bids are not truly comparable, even if the numbers appear side by side on the same spreadsheet.
A remodel scope of work is how you begin removing those blanks.
The scope does not have to be written in contractor language to belong to you. Its purpose is to document your decisions clearly enough that professionals can respond to the same project.
A remodel scope of work describes more than the result
Your desired outcome answers:
What needs to be different when this project is finished?
The scope answers:
What work are we actually proposing to do to make that happen?
For example:
Desired outcome:
Two people can use the kitchen comfortably, everything used daily has storage, and the room feels connected to the rest of the house.
That still does not tell anyone what to price.

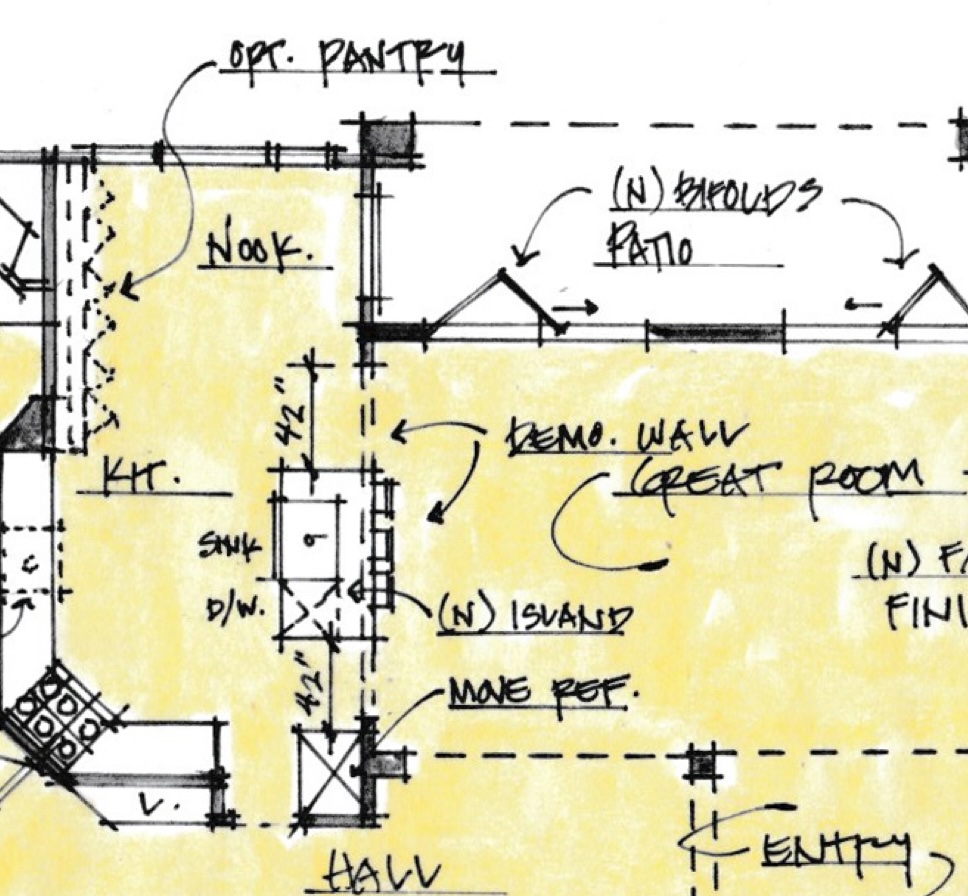

A scope begins translating that outcome into work:
- Remove existing cabinets and countertops
- Remove wall between kitchen and dining area, subject to structural review
- Relocate refrigerator
- Relocate sink and associated plumbing
- Add island with seating for four
- Replace flooring through kitchen and adjoining dining area
- Add recessed and task lighting
- Modify electrical as required for new appliance and lighting locations
- Patch and paint affected walls and ceilings
Now a contractor has something to respond to.
But even this is only the beginning.
Define the edges of the project
One of the most common scope problems is not the work in the middle. It is what happens at the edges.
If you replace the kitchen floor, where does the new flooring stop?
At the doorway? The hallway? The stairs? The adjoining family room?
What happens where the new flooring meets existing tile? Is there a height difference? Are the baseboards staying? Are they being removed and reinstalled, or replaced? Do doors need to be cut down? Does the flooring go under the cabinets? What happens at the dishwasher and refrigerator?
Those decisions may sound small when you are standing in a showroom looking at flooring samples. They are not small when one contractor includes them, another excludes them, and a third discovers them after demolition.
A well-defined scope identifies where the work begins, where it ends, and what happens where new work meets existing construction.
Watch for the onion project
I sometimes call these onion projects.
An onion project is one where the first task exposes another layer of work, which exposes another, and then another.
Move a kitchen sink and the plumbing changes.
Move the plumbing and you may need to open walls or concrete.
Open the wall and you may discover older electrical, plumbing, framing, or previous repairs that need attention.
Change the flooring and you may now have transitions at adjoining rooms, baseboard work, door clearances, appliance-height issues, or flooring that no longer aligns with neighboring spaces.
None of this necessarily means the project should not be done. It means the consequences of the first decision need to be followed far enough to understand the likely scope.
That is one of the most important parts of planning.
You cannot predict every hidden condition, but you can identify the work that is reasonably foreseeable before contractors price the project.
Even a bathroom can need drawings
Homeowners sometimes assume drawings are only necessary for additions or major structural work.
They are not.
Even a relatively small bathroom remodel may need drawings if fixtures are being relocated, walls are changing, a shower is being rebuilt from the studs, or plumbing is being moved in a slab.
Before construction begins, someone should know whether the proposed shower actually fits, whether clearances work, whether the door swing creates a conflict, whether the toilet has enough space, where the shower valve and drain will land, and whether the planned layout can actually be built.
Moving a drain through a wood floor is one problem. Moving one through a concrete slab is another.
That affects labor, demolition, plumbing, waterproofing, patching, schedule, and cost.
The planning also creates an opportunity to look at what is already there.
If a fifty-year-old house has original copper piping running through the slab and the bathroom is already being opened up, it may make sense to evaluate whether the affected plumbing should simply be rerouted, or whether the larger house is approaching the point where a repipe should at least be considered.
That does not mean every bathroom remodel should turn into a whole-house plumbing project.
It means you should recognize the opportunity while access is available, understand the options, and make the decision deliberately rather than discovering it halfway through construction.
The documentation should match the project
A written scope is the starting point, but it is not always enough.
As a project becomes more complex, the documentation should become more detailed.
That may include:
- Existing-condition measurements
- Floor plans
- Demolition plans
- Proposed floor plans
- Interior elevations
- Cabinet drawings
- Lighting plans
- Electrical layouts
- Plumbing layouts
- Structural drawings
- HVAC design
- Energy documentation and testing where applicable
- Fixture schedules
- Finish schedules
- Appliance specifications
- Door and window schedules
- Quantity takeoffs
- Written assumptions and exclusions
Not every project needs every document.
The question is whether the people pricing the work have enough information to understand the same project.
A cosmetic powder-room update may need little more than a detailed scope, dimensions, and selections.
A bathroom with a relocated shower, moved plumbing, new lighting, altered walls, and slab work should be drawn.
A kitchen that changes layout, removes walls, relocates utilities, alters lighting, and affects multiple adjoining rooms needs considerably more information.
The complexity of the project determines the level of planning, not just the dollar amount.
Plans make pricing more comparable
There is a practical reason for doing this work before bidding.
The more decisions that remain undefined, the more assumptions each contractor has to make.
One contractor may include twelve recessed lights.
Another may assume eight.
One may include patching and painting the adjoining hallway where the flooring changes.
Another may stop at the kitchen doorway.
One may include plumbing modifications through the slab.
Another may carry an allowance and decide the actual cost later.
The totals may look dramatically different, but the contractors may not be pricing the same work.
That is why larger and more complex projects are difficult to bid accurately without plans.
A good set of remodel plans and drawings gives everyone the same layout.
A lighting plan gives everyone the same fixture locations.
A fixture schedule gives everyone the same plumbing requirements.
A takeoff gives everyone the same quantities.
The more you define before pricing, the less room there is for each bidder to invent a different version of the project.
Counts and takeoffs matter too
Plans tell contractors where things go.
Counts and takeoffs help tell them how much work there actually is.
A takeoff is a measured count of the materials or work involved, such as square feet of tile, the number of doors, or the number of light fixtures.
“Add recessed lighting” is vague.
“Install fourteen recessed fixtures at the locations shown on the lighting plan” is much more useful.
“Install backsplash tile” leaves the quantity open.
“Install approximately forty-two square feet of backsplash tile, including returns at the window” gives the bidder something measurable.
“Replace interior doors” may mean five doors to one contractor and eight to another.
When the quantities are known, documenting them helps keep everyone pricing the same job.
That becomes particularly valuable when subcontractors are bidding portions of a larger project.
Separate known decisions from open decisions
You do not need every finish selected before you can begin planning.
You do need to know which decisions are made and which are still open.
For example:
Known:
- Shower will remain in current location
- Tub will be removed
- Vanity will increase from 60 inches to approximately 72 inches
- Bathroom will receive new flooring and lighting
- Existing door location will remain
Open:
- Exact vanity style
- Countertop material
- Faucet selection
- Mirror configuration
- Decorative light fixtures
- Tile selection
That distinction matters.
An undecided tile color does not prevent someone from developing a bathroom plan.
An undecided shower location does.
Treating every open decision as equally important makes the planning process feel much harder than it needs to be.
Selections are part of the scope, but they are not the scope
Homeowners often begin with products because products are visible.
Tile. Faucets. Appliances. Lighting. Cabinets. Flooring.
Those decisions matter, but they do not replace the project definition.
You can know exactly which faucet you want and still not know whether it is deck-mounted or wall-mounted, where the rough plumbing needs to be located, whether it conflicts with the mirror, or whether the sink and backsplash configuration will accommodate it.
The same is true throughout a remodel.
The goal is not to make every design decision at once.
The goal is to identify which decisions affect the work, when they must be made, and what information contractors need in order to price and build accurately.
A better bid starts before the contractor arrives
The purpose of this planning is not paperwork for its own sake.
It is to make bidding useful.
Ideally, each contractor reviewing the project receives substantially the same information:
- The same scope
- The same drawings
- The same quantities
- The same known selections
- The same allowances where selections remain open
- The same assumptions
- The same exclusions
Then the bids begin to mean something.
You can compare price, approach, schedule, communication, overhead, and the contractor’s understanding of the project instead of trying to reverse-engineer which bidder included what.
That is what apples-to-apples pricing actually requires.
Start simple, then add detail where it matters
You do not need to become an architect, engineer, estimator, plumber, electrician, and general contractor before remodeling your house.
You do need enough project definition to know what you are asking people to price.
Start with the remodel scope of work.
Follow each major change far enough to understand what else it touches.
Draw the work when layout or systems are changing.
Document the decisions that affect construction.
Identify what is still unknown.
Add schedules, counts, and takeoffs when the complexity of the project makes them useful.
The goal is not to make remodeling complicated.
The goal is to deal with the complexity that is already there before it becomes expensive.
Continue with Article 3: Establishing Remodel Priorities and Constraints, where you will separate what must happen from what can change when scope and budget meet.
Plan before assumptions become expensive
Master Build Advisor helps homeowners develop a project before construction decisions become expensive. We clarify scope, identify likely downstream work, evaluate feasibility, develop planning documents, test budgets, and prepare projects for meaningful contractor pricing.
For more complex work, that may include coordinating the drawings, specifications, schedules, quantities, and other documentation needed so contractors and subcontractors are pricing the same project.
The objective is not more paperwork. It is fewer assumptions.
If construction services are appropriate and the timing is right, BristolCo may be available to carry the completed plan into construction. You are always free to take your scope and planning documents to another qualified contractor. CSLB License #1070344.
Plan first. Define the work. Price the same project. Build with clarity.
Your project. Your scope. Your decisions.
